1. Prove the process manually
Before automating, run the task once in chat. Attach the Renewal Policy page and Renewals table, then ask:Find renewals due in the next 90 days. Group them by account owner, flag high-risk records and records without a next action, and produce a CSV plus a concise summary.Review the result with the process owner. Automation should preserve an agreed process, not hide an unresolved one.
2. Describe the Workflow contract
Open Workflows → New workflow, or ask from chat:Create a workflow named Weekly renewal review. It should accept an optional as-of date, read the Renewals table, select records due within 90 days, group them by account owner, flag high-risk or incomplete records, write a dated CSV to Project files, and return a Markdown summary. It must fail without updating records if the table cannot be read.Include:
- trigger and timezone;
- input types and defaults;
- data and Knowledge references;
- output files or records;
- side effects;
- retry and failure rules.

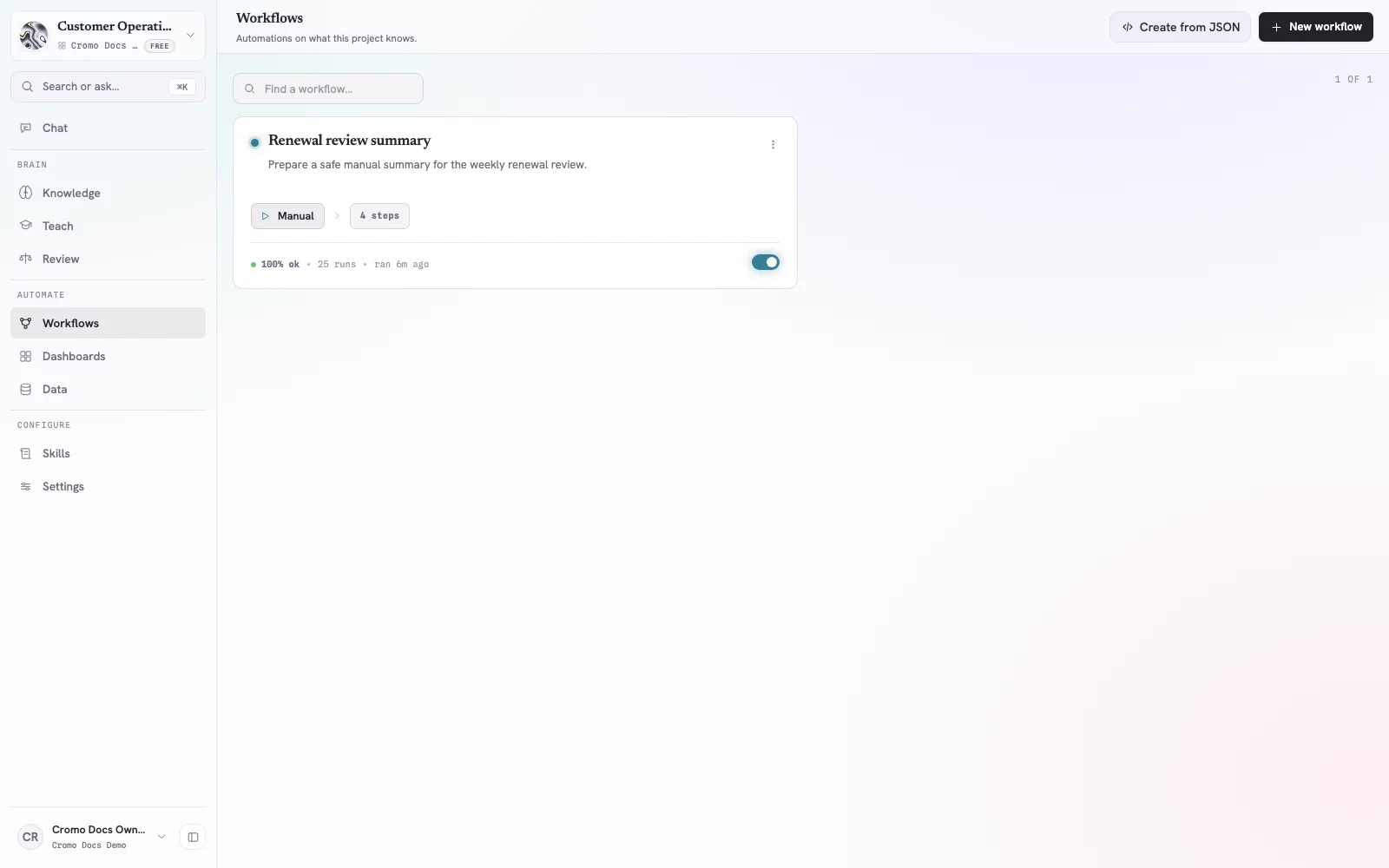

3. Inspect the definition

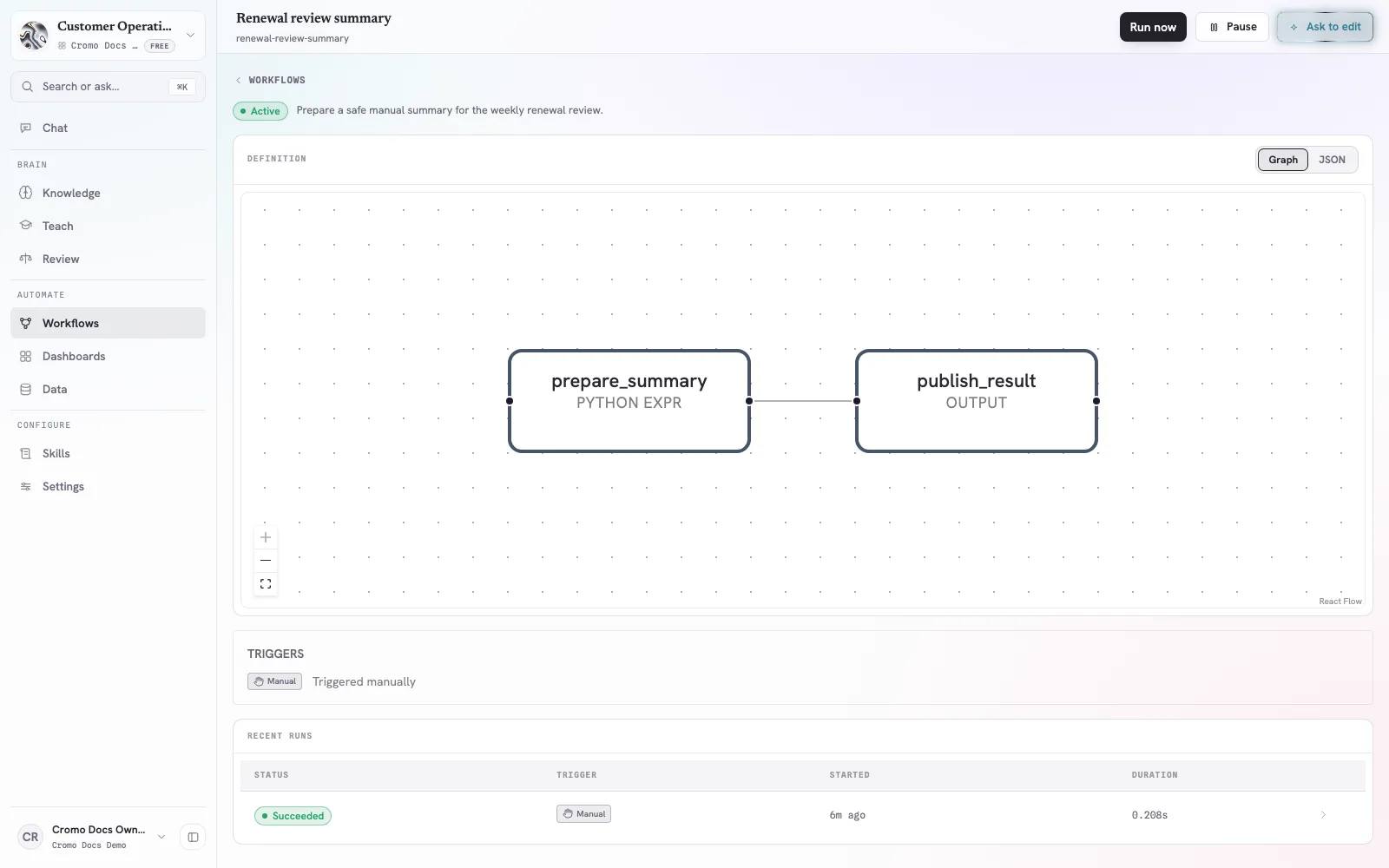

Open the Workflow and use the graph view to follow the execution order. Click each node and check:- what input it receives;
- where mapped values come from;
- what output it produces;
- whether it can call an external system;
- what happens when it fails;
- whether fan-out branches are aggregated correctly.
4. Ask for changes
Use Ask to edit instead of changing the definition by hand. For example:Change the workflow so an empty result still creates a summary saying that no renewals are due, but does not create a CSV. Add the table name and as-of date to every failure message.Reopen the graph and verify the changed branches.
5. Run a safe test
Select Run now and provide representative inputs. If the Workflow accepts a file or Project reference, choose it in the generated input form. File inputs can be up to 10 MB each. For the first test:- use a copy or a non-critical record set;
- disable unnecessary external writes;
- choose a date that produces known results;
- tell the process owner when the run will happen.
6. Inspect the run
Open the run detail and verify:- the run status;
- resolved arguments;
- each node’s input and output;
- retries or skipped branches;
- generated files;
- external side effects;
- aggregate results after fan-out.
7. Activate a trigger
After a successful manual test, configure the required trigger:- manual only;
- schedule;
- webhook;
- supported event.
8. Monitor and pause
Review runs regularly, especially after changing:- a Source or Knowledge policy;
- a Data model or table;
- connector credentials;
- Workspace or Project membership;
- the Workflow definition.
Release checklist
- The process owner approved the expected result.
- Inputs and outputs are typed and named clearly.
- Side effects are limited to the intended systems.
- Failure and retry behavior were tested.
- A manual run completed with representative data.
- The trigger and timezone are correct.
- The owner remains a member of the Project.
- Someone is responsible for reviewing failed runs.
